Transocean and the deepwater inflection: When supply discipline meets structural demand
Premium Fleet, Constrained Supply, and the Global Exploration Resurgence
If you find something wrong in the text I would appreciate if you wrote to me about it so i could change it. Without further ado let’s delve into this article.
Introduction: The market reset
The offshore drilling sector stands at a crossroads. After a decade of excess capacity, balance-sheet deterioration, and the generational scrap-and-burn of the 2015-2017 downturn, the market for ultra-deepwater drilling rigs has undergone a fundamental reordering. The supply of high-specification vessels has contracted, newbuild orders have essentially ceased, and the few shipyards building new capacity have either gone bankrupt or divested from shipbuilding. Meanwhile, exploration activity is stirring again. Oil majors and independent producers are dusting off prospect portfolios. “Customers are beginning to plan entire rig lines around exploration” (transocean q3 conference call), something that would have seemed reckless just 18 months ago.
Transocean finds itself uniquely positioned within this rebalancing. As the world’s largest offshore drilling contractor, measured by ultra-deepwater fleet size and asset quality, the company controls perhaps the most valuable collection of rigs at a moment when we may have an inflection. My analysis examines why Transocean’s fleet composition, capital structure, and market timing could lead to some outsized returns in the cycle ahead, while acknowledging the execution risks and financial leverage that could make the whole thing implode.
A superior fleet

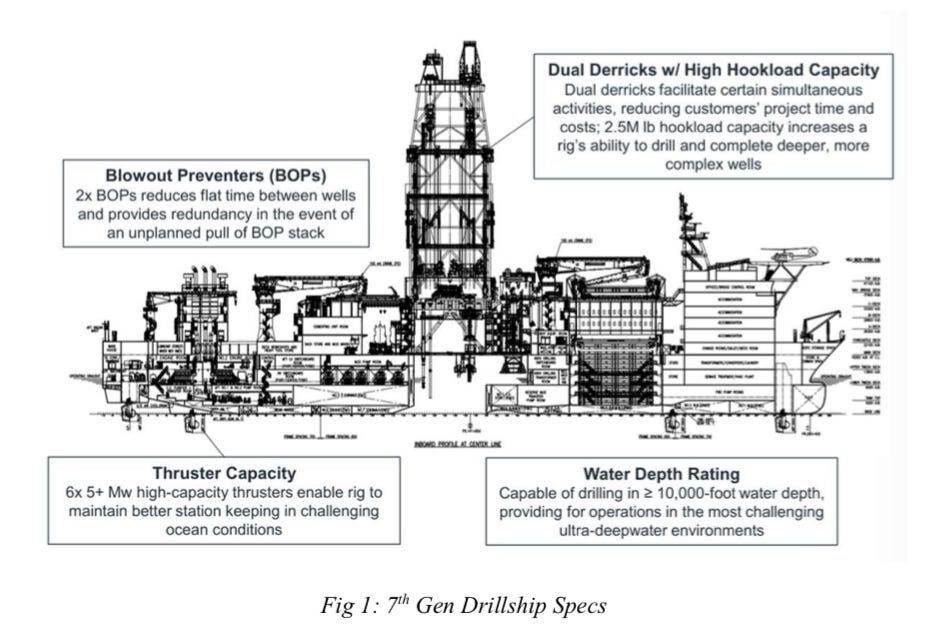

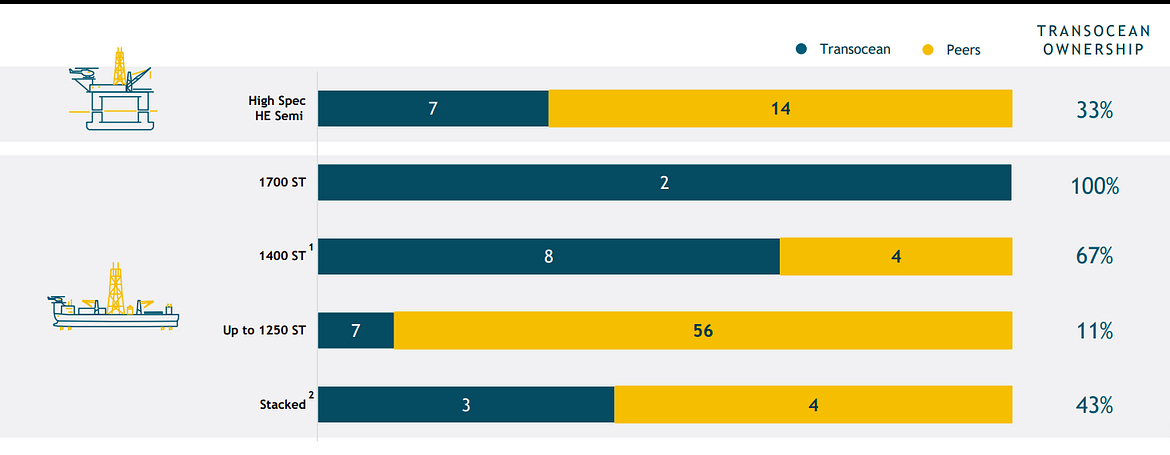

Even though there may be quite a few 7-generation (7G) ships(around 35-40 active) around the world it is important to remember that not all 7G drillships are created equal, and this distinction is a core part of Transocean’s competitive moat. The company operates 27 deepwater units. What separates these vessels from the rest of the market isn’t just age or cosmetic newness, but rather the engineering specifications and capabilities embedded within them.
But they also have the only two 8G drillhips in the world. Take the Titan as an example. This 8G drillship operates with specifications that only a handful of vessels globally can match. It’s one of only two (or maybe three rigs if you count the Valaris DS-16 7G+ drillship which has been upgraded but is not as “proven” as the 8G ships) in the world that can reliably handle wells requiring sustained pressures at 20,000 psi, ultra-high-pressure conditions that most contractors simply cannot manage(weaklings). Chevron’s Anchor project for example in the Gulf of Mexico/America is exactly this type of project. The well architecture demands a rig with redundant systems, precise pressure control, and equipment specifications that go well beyond what a standard deepwater unit offers. Anchor requires managed pressure drilling capabilities, sophisticated well control systems, and engineering teams experienced in extreme-pressure scenarios. A standard 6G or older 7G drillship cannot do this work. This isn’t a competitive disadvantage that can be overcome with superior day rates or contracting ingenuity. It’s a technical barrier that eliminates competitors from the bidding process altogether.
The Atlas operates similarly. As an 8G vessel, it carries the payload, processing capacity, and drilling automation needed for complex subsalt wells in the Gulf, where operators are chasing older Miocene structures and deepening wells into increasingly hostile geological formations. The dual activity capabilities on these rigs mean well operations can proceed on multiple intervals simultaneously, collapsing drilling timelines that would otherwise require sequential operations. For an operator spending $500 million to $1 billion on a single well program, the ability to compress the drilling schedule by weeks or months justifies paying a significant premium for rig capability. And operators of course want to spend as little money as possible. Pemex has been focusing on cost reductions through reforms and refinery optimizations (more comments about this in the Transocean Q3 conference call).
This creates a straightforward economics story. A competitive but maybe mid-tier deepwater rig in today’s market averages day rates somewhere between $400,000 and $500,000. Transocean’s top-tier 7th-generation assets command rates in the range of $500,000 to $650,000 or higher when pursuing premium work. That $150,000 to $250,000 per day differential isn’t trivial. Over the course of a multi-year contract, the spread compounds to hundreds of millions of dollars in incremental revenue. A single year-long extension on an asset like the Atlas can add more than $200 million in contracted future revenue. When you multiply that across a fleet of multiple premium units, the difference between being capable and being marginal becomes a massive value driver.
The point extends beyond US Gulf shale. Transocean’s harsh-environment semisubs, particularly the Poseidon and Aquila, command similar premium valuations in Norwegian waters specifically because they’re engineered for extreme conditions. Older or less capable units cannot operate safely in the North Sea environment, which means there’s no substitute competition. In Norway, you either have capable tonnage or you don’t pursue the project. This geographic and technical diversity means Transocean isn’t competing on price in a commoditized market. It’s supplying specialized services for which there are limited alternatives.
The supply collapse
To appreciate why Transocean’s fleet composition matters today, one must understand the magnitude of the supply-side restructuring that has occurred. Prior to 2015, the offshore drilling industry was characterized by chronic oversupply. Yards around the world, from South Korea to Singapore to the Gulf of Mexico/America, had been constructing drillships and semisubs at an unsustainable pace with small down payments. When oil prices collapsed and customers slashed capital budgets, the industry entered a deflationary death spiral. Rigs stacked. Debt mounted. Operators went bankrupt. While shipyards worldwide experienced devastating losses, those that had been constructing rigs faced particularly severe challenges. Keppel Offshore & Marine, for instance, divested its rig-building business in 2021, while Daewoo Shipbuilding (now Hanwha Ocean) underwent major government-backed restructuring due to losses from the downturn.

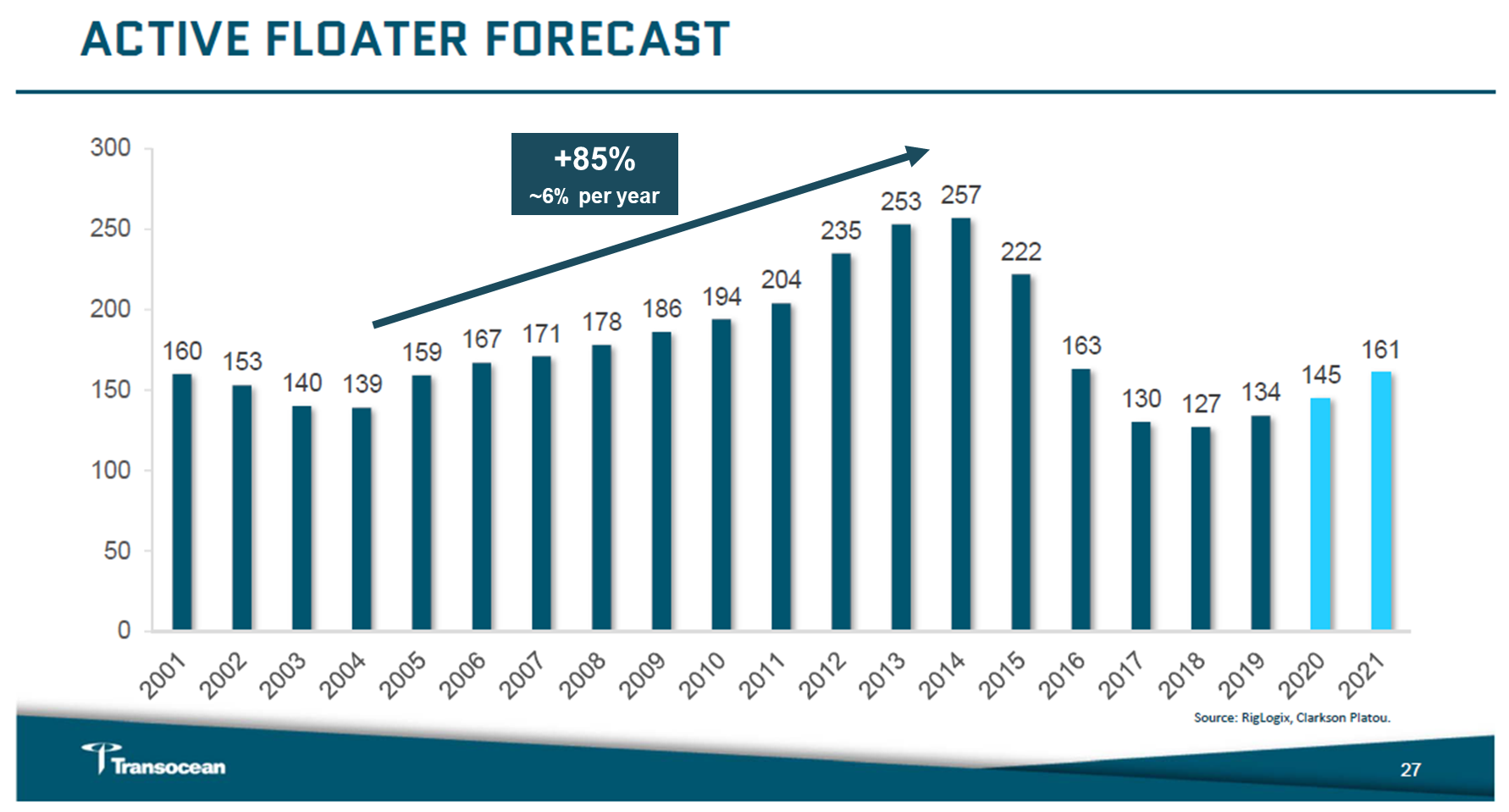

The global deepwater rig market is characterized by a scarcity of newbuild supply. There are no meaningful newly committed orders for future deepwater drillship construction, and the limited supply available comes from stranded newbuilds left over from the previous cycle. This is not a cyclical dip. This reflects a structural decision by the last remaining shipyards that deepwater rig newbuilds are economically unattractive unless day rates and contract terms align with unrealistic scenarios. A vessel cost to construct new is estimated between $600 million and $750 million. To justify that investment with a reasonable return, a newbuild rig requires day rates in the $800,000 to $900,000 range on long-term contracts lasting seven to ten years, with $300 million to $400 million in cash up front from the customer or rig owner. These terms are essentially not available in the current market, which means the odds of any significant newbuild ordering cycle over the next three to four years remain low. Even if crude oil prices rise substantially, the capital requirements and financing constraints for shipyards make a rapid expansion unlikely. And even if somebody coughed up the cash for a newbuild it would still take 3-5 years (around 4-5 for a 8G) for it to finish all meanwhile Transocean is printing obscene amounts of cash flow.
The implication is counterintuitive: the scrapping and stacking of the downturn was not wasteful destruction. It was supply discipline. With newbuilds economically unavailable, and aging cold-stacked rigs expensive to reactivate (typically $100 million to $200 million per vessel), the only way the market can satisfy incremental demand is by returning the best available idle rigs to service. This creates a tiered reactivation sequence. High-specification units like Transocean’s top-tier assets, if stacked, would return first and command premium rates. Lower-spec or aging tonnage might reactivate but at modest rates that barely cover operating costs. The worst units will probably never return at all, either getting scrapped for parts or left to rust.
Transocean currently has three deepwater drillships remaining in cold stacks (Ocean Rig Apollo, Athena, and Mylos), while the company announced in August 2025 that it plans to dispose of five older stacked rigs through recycling or alternative use. The company’s position is that it will not fund reactivation costs itself. If operators want a cold-stacked RIG rig, they will need to fund the reactivation as part of a contract. This is a disciplined stance that protects Transocean’s cash flow but also signals that activation of marginal assets is unlikely. More interestingly, cold-stacked rigs serve a secondary purpose within Transocean’s strategy: parts cannibalization. As certain systems age or become obsolete, Transocean can harvest components from stacked vessels to maintain the operating fleet. This creates additional value from otherwise dormant assets and extends the life cycles of working rigs.
Demand signals, the comeback of exploration and lead times
“The number of conversations occurring for work hasn’t been this active for years” from the Transocean Q3 conference call.

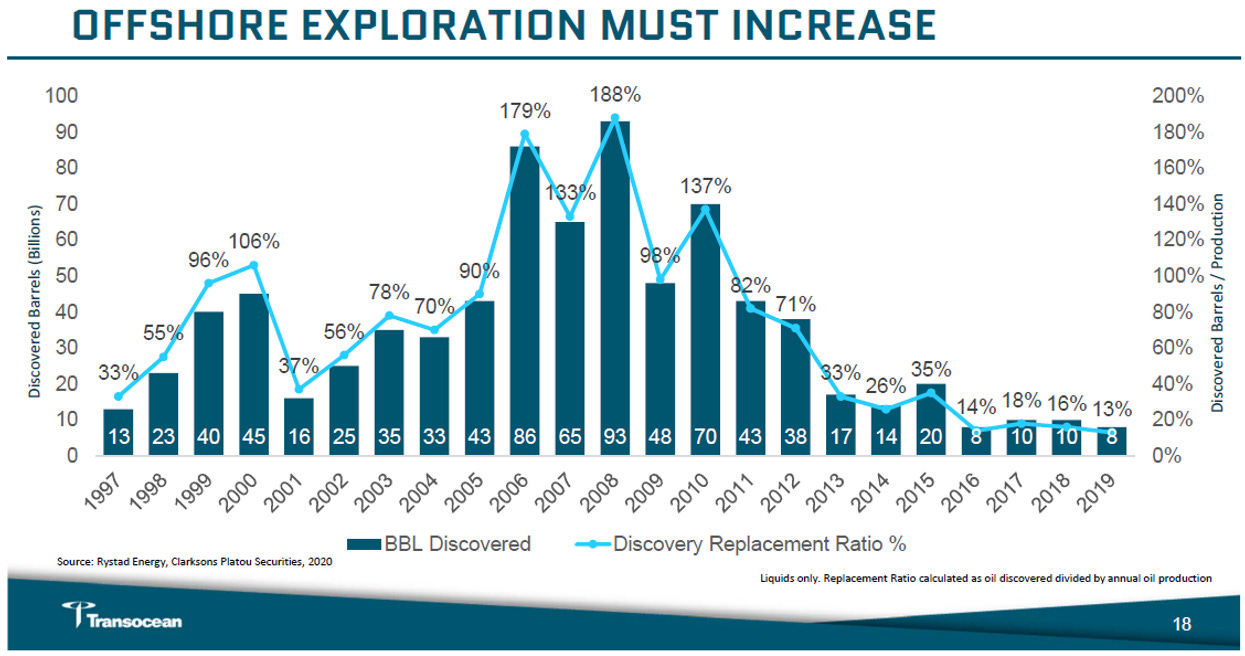

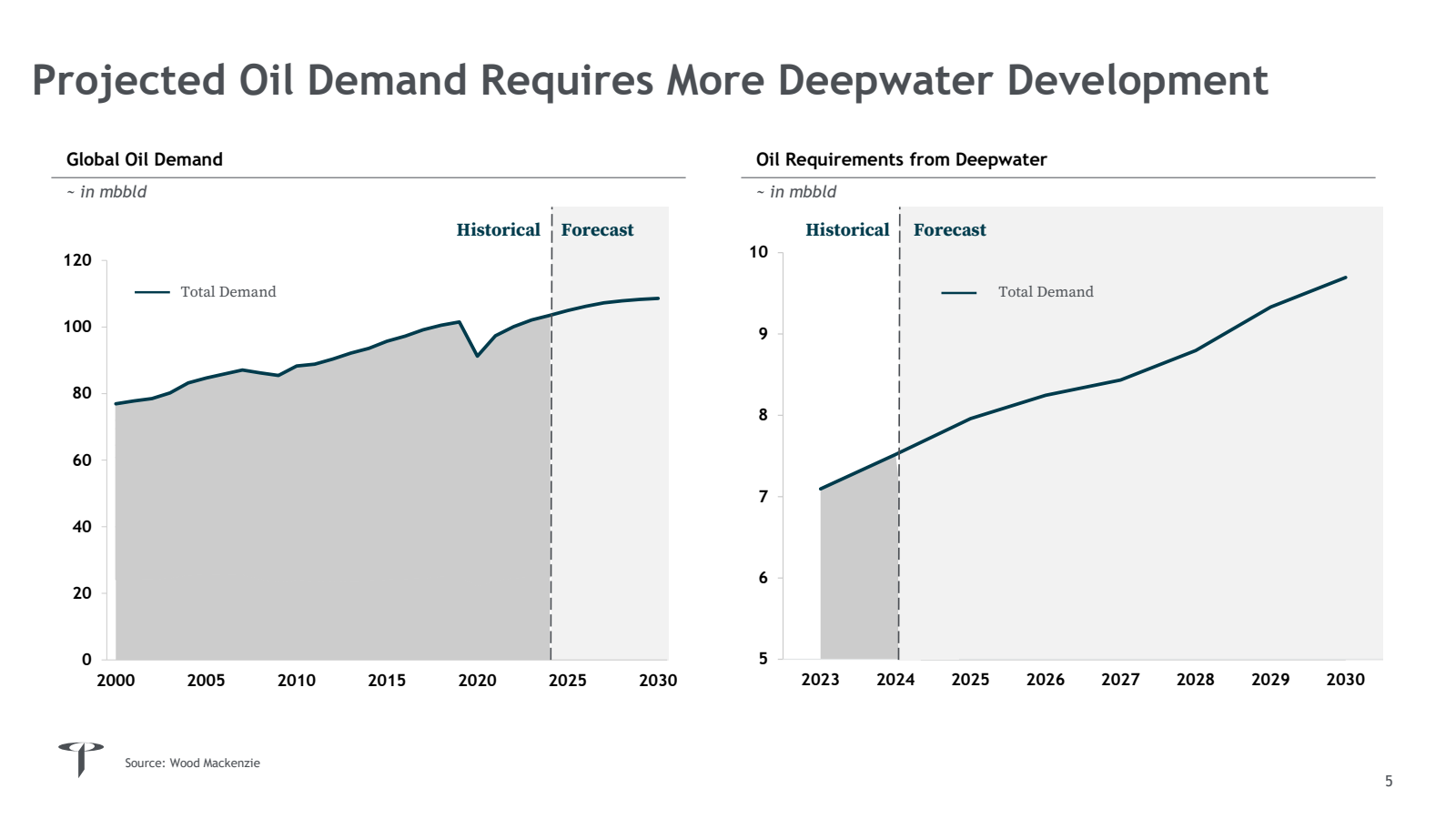

2025 has witnessed a marked shift in customer behavior and forward planning. After years of capital discipline and cash repatriation, oil majors (NOCs) and select independents (IOCs) have begun committing to exploration campaigns that require multi-year rig commitments. The USGS and similar agencies estimate that hundreds of billions of barrels of undiscovered recoverable oil remain globally, with a substantial portion in deepwater settings in the Gulf of Mexico/America, Southeast Asia, and West Africa. Reserve replacement has become a priority for companies that spent the previous five years running down reserves without replacing them.
This realization is driving a qualitative change in conversation frequency and commitment timelines. Industry feedback reflects that the number of active conversations around rig commitments for exploration campaigns has reached levels not seen in years. Customers are planning not single-well commitments but rather multi-rig, multi-year programs. These conversations are extending visibility and creating the opportunity for long-term contracts at rates that support strong cash generation.
An important dynamic reinforcing sustained rig demand is the long lead time between exploration commitment and drilling operations. When an operator commits to an exploration campaign targeting a specific prospect or play, the contracting process typically begins 12 to 24 months before the rig actually deploys to the well. This creates a forward booking pattern that provides visibility into utilization and pricing. In recent industry commentary, observations that “the number of conversations occurring for work hasn’t been this active for years” reflect this forward-looking pipeline. Customers planning exploration campaigns are locking in rig commitments well in advance to ensure they have committed tonnage at known rates.
This dynamic differs notably from the 2015-2017 downturn, when customers deferred projects or cancelled contracts on short notice, creating massive supply overhang and rate depression. The current environment features customers making longer-term commitments with earlier booking windows. This benefits contractors like Transocean that can provide certainty through premium assets with excellent track records.
Regional market activity’s

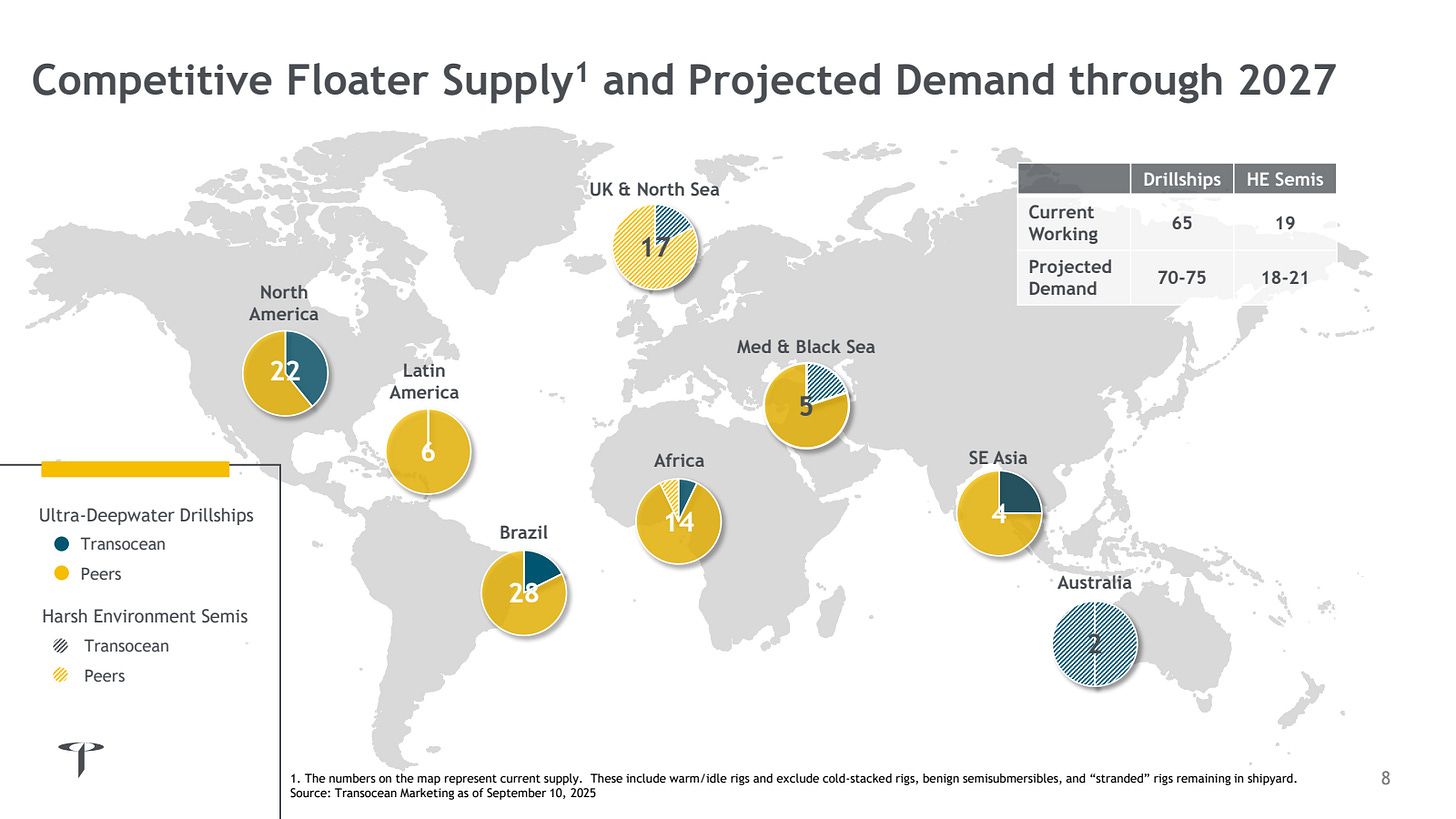

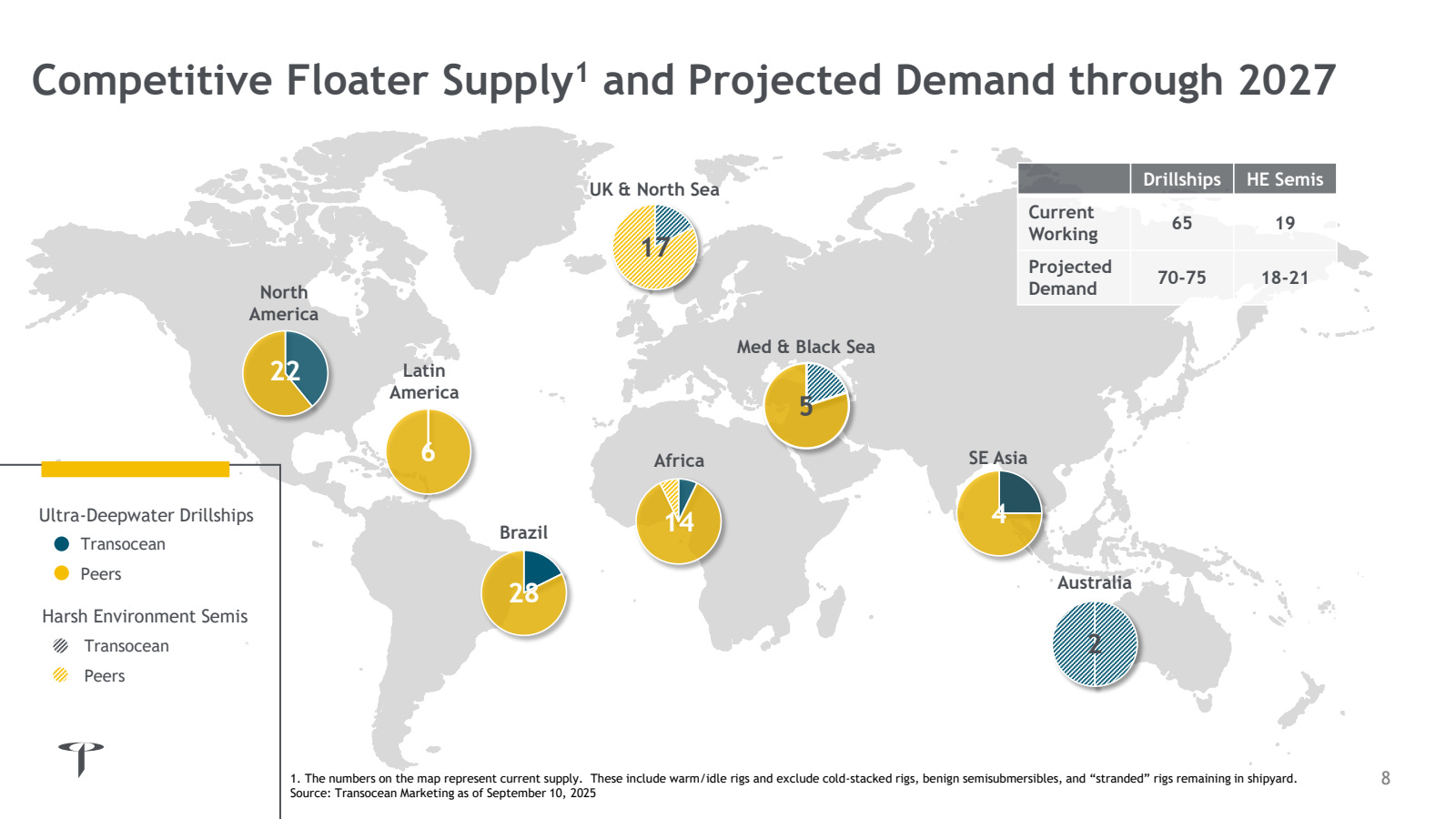

The pace of contracting activity across deepwater markets has shifted markedly through 2025, with Transocean’s experience reflecting broader industry momentum that management described as entering an “exploration boom” expected to unfold fully in 2027-2028. Understanding where this demand is concentrated, and how different regions contribute to utilization and day-rate expectations, illustrates the diversity of potential costumers.
The acceleration story
One of the clearest quantitative indicators of market tightening came from Transocean’s third-quarter earnings call, where management disclosed that contract award rates measured in rig-years had accelerated substantially through the year. At the start of 2025, Q1 saw 12 rig-years awarded. Q2 improved to 14 rig-years. Q3 delivered 18 rig-years. Management noted that for Q4, they expect 23 rig-years in Brazil alone; nearly double the initial baseline. Management noted that “many programs [are] going longer” with customers now willing to commit to multi-year engagements rather than the shorter-term contracts that characterized the recovery’s early phases. This shift reflects growing confidence among operators that deepwater projects justify sustained capital commitments, and that rig availability in the future cannot be taken for granted.
Critically, the conversations underlying these contract extensions are increasingly forward-looking. Transocean indicated that for four drillships rolling off contracts in 2026 (Skyros, Mykonos, CG2, and Proteus) management is in “active discussions” for follow-on work, with the expectation that “there won’t be much idle time.” Early soundings on 2027-2028 work are already underway, a pattern that would have been unthinkable in the weak market conditions of just months prior. The combination of lengthening contracts and extending forward visibility creates a positive feedback loop: customers lock in rigs earlier to secure capacity, which tightens the market further and supports incremental day-rate increases.
Some markets to keep an eye on:
1. Brazil: Anchor market
Petrobras remains Transocean’s most consistent deepwater customer, with the company maintaining selective exposure to Brazilian deepwater projects. The Deepwater Mykonos recently concluded a long-running engagement in Brazilian waters, while other assets in Transocean’s portfolio address operators across different geographies. The company’s discipline around contract selection prioritizing premium rates over maximizing utilization(unlike Noble) reflects confidence that deepwater demand will support selective positioning.
What differentiates Brazil from other markets is the consistency of its drilling program. Petrobras operates on multi-year development plans with predictable rig demand, creating baseline utilization that contractors can rely upon even during commodity price volatility. The operator’s focus on pre-salt plays, which require high-specification drillships with advanced well control and deepwater drilling capability, narrows the competitive field to a handful of contractors with the right fleet composition.
Management commentary during the earnings call underscored that Brazil’s demand will remain robust into 2026 and beyond. Petrobras is targeting production growth from its offshore portfolio, and discovered resources in Brazilian waters continue to justify development drilling campaigns. For Transocean Brazil provides both revenue stability and strategic optionality: assets contracted there can roll off into higher-rate follow-on work or be repositioned to other markets as opportunities arise.
2. The gulf of Mexico/America: Drill baby drill
